Scheduling

On this page

What it does: generates shifts and breaks that cover the agents your forecasts need, for the people on each line of business, within their contracts, availability, time off and the limits their labor rules make hard. You adjust a draft, then publish it to agents.

Use it when: you plan each period, and again when something changes during one: people moving or leaving, a forecast republished, time off approved.

You need

  • A published forecast for each line of business, covering the weeks you're scheduling. See Forecasting and staffing.
  • Shift patterns for each line of business: the shapes shifts may take. Set them up first: see Shift patterns.
  • People on their lines of business, with their contract hours, and binding availability where it matters.
  • Whose labor law applies, under Settings → Organization, and per site or per person if it differs. See Labor rules.

You get

  • A draft of shifts, breaks and lunches for everyone, for each day of the period.
  • Its coverage: the share of the hours needed that are staffed, the hours short and the hours over, for the period, a week or a day.
  • A labor-law check of every shift.
  • Once published, each agent's schedule on their phone or computer, and adherence measured against it.

The Schedule page's Start here checklist shows what's still missing.

Set up shift patterns first

A draft only makes the shifts your patterns allow, so they come before your first schedule. A shift pattern says when shifts may start, how long they run, and where breaks go. Add them under Settings → Shift patterns, at least one for each line of business.

FieldWhat it sets
DaysThe weekdays it's used on.
Works betweenThe earliest start and the latest end, like 07:00 and 22:00, and the step between starts, like every 15 minutes. Each length starts no later than the latest end less its length: from 4 to 6 hours ending by 22:00, a 6-hour shift starts by 16:00 and a 4-hour one by 18:00. Check the next day for an end after midnight, for evenings and nights.
LengthOne length, or a range with a step, like 4 to 6 hours every 30 minutes.
Different hours on some daysA day that works other hours, with its own start, end and length: weekdays from 07:00 for 8 hours, say, and Saturday from 09:00 for 6, in one pattern. A day left blank works the hours above.
ForFull time, part time or temporary staff, and the lines of business that use it.
Breaks, lunch and other activitiesEach has a length and a window, counted after the start, before the end, or by the clock: training at 09:00 for three hours, say, which every shift then holds. Each is paid or unpaid as its activity is (breaks paid, lunch unpaid), and says which shifts it's for, by length, and, if not every day, the weekdays it's on.

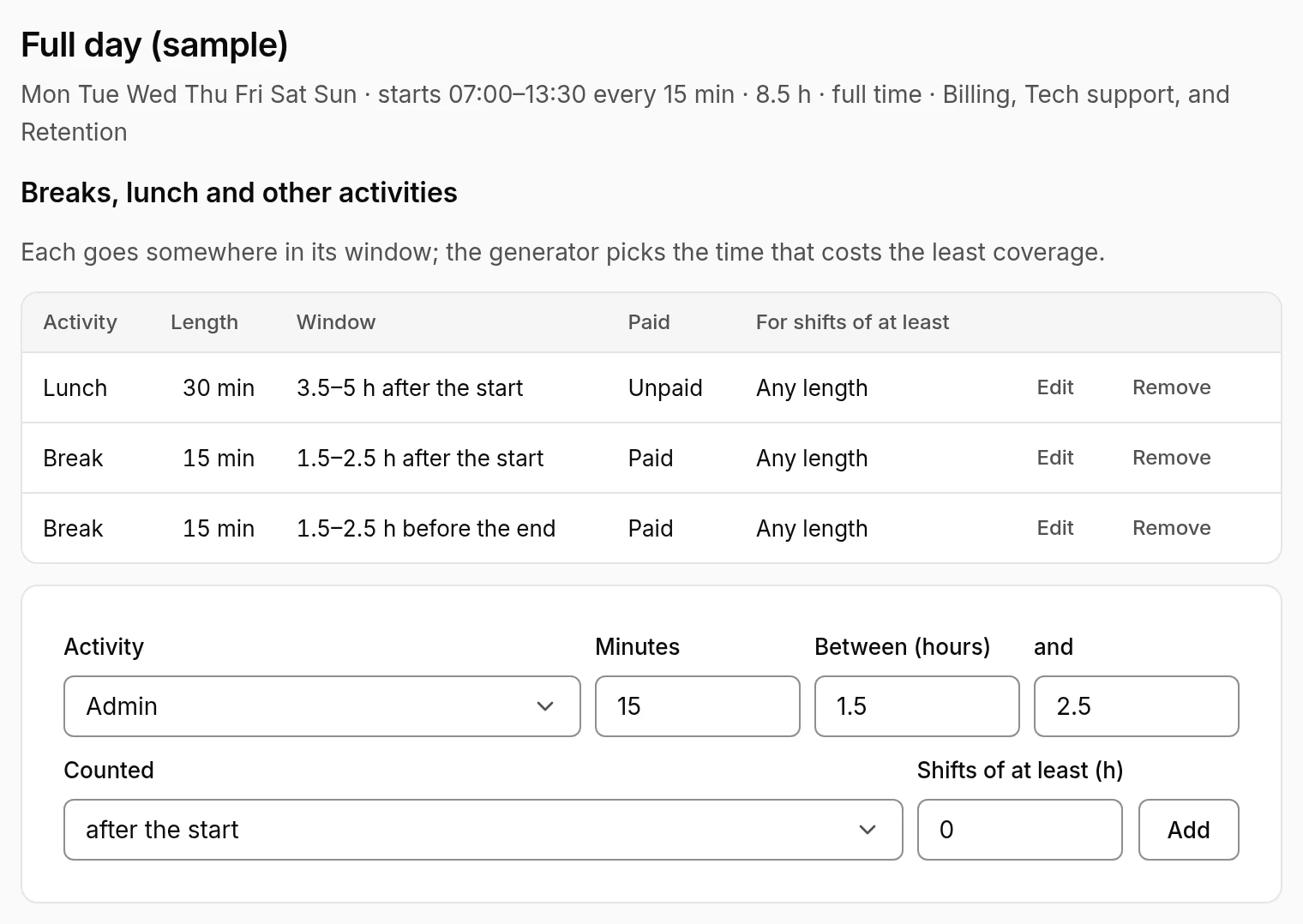

The Full day (sample) shift pattern: every day, works 07:00 to 22:00 starting every 15 minutes, 8.5 hours, full time, with a lunch 3.5 to 4.5 hours after the start and two breaks, and their windows.
Settings → Shift patterns → a pattern.

Keep the hours a pattern works between inside those your forecast needs people. If they run outside them, the draft says so: Billing: 211 h scheduled when the forecast needs nobody, mostly 06:00–07:00. Patterns can run past midnight: see Night shifts.

Pattern sets, for training and nesting

Some people need their own shifts for a while, like a new-hire class in training and then nesting. Give them a pattern set instead of entering their activities by hand:

  1. Make their patterns. Add the shifts they need under Settings → Shift patterns, like Training from 09:00 to 15:00 on weekdays. Don't tick any line of business, so nobody else gets them.
  2. Make the set. Under Settings → Pattern sets, add one, like New hire training, and tick its patterns.
  3. Give it to people. On the set's page, under Give it to people, tick a whole class at once (find a team by name, then Select all), with a From date, and an Until date if it ends. Or give it to one person on their page, under Pattern set. People have one set at a time: someone who already has one then keeps it, and is named.
  4. Generate. Then generate the schedules for those dates again.

While someone has a set, their shifts come only from its patterns, whatever their employment type. Days its patterns don't run on are days off. Everyone else on their lines keeps the lines' patterns. Their contract, availability, time off and labor law still apply, and they still count towards their lines' coverage.

Put a training block in their pattern as an activity by the clock, on the days it's on: Training, 180 minutes, between 9 and 9 hours by the clock, only on Mon Tue Wed goes at 09:00 for three hours on those days, every shift then holds it, and breaks go around it. Evening out breaks leaves it where it is.

Besides breaks, lunch, training, coaching, nesting, admin and team meetings, planners add your organization's own activities, like internal PCI training, under Settings → Activities → Add an activity, with what each counts as and whether the client pays for it. Switch one off when you're done with it: it isn't offered any more, and what's already scheduled stays. Take it out of the shift patterns that place it too, or new drafts still schedule it.

Activities by the clock may sit back to back, so a whole training day can be laid out: training, a break at 11:00, training from 11:15, lunch and so on. Activities placed after the start or before the end keep a step clear of the others. If a pattern leaves an activity no room, the draft says so, such as Break couldn't be placed on 10 shifts from New hire training, rather than leaving it out silently.

Start times close together

Left to itself, a draft picks each person's best shift each day, so someone can start at 07:00 on Monday and 13:00 on Tuesday. To keep each person's week steadier, set Start times in a week vary by at most on the line of business, in hours (Settings → Lines of business → the line → Edit). With 2, someone who starts at 08:00 on Monday starts between 06:00 and 10:00 the rest of the week. 0 gives them the same start every day.

  • Generation still picks the best shift each day, among those that keep the week within the limit. A day with none that fits stays a day off, and the draft names anyone that leaves short of their contract's hours.
  • It goes by the time on each person's own clock, round the clock: 23:30 and 00:30 are an hour apart, so night shifts can start either side of midnight. A night starting at 22:00 and a day starting at 06:00 are 8 hours apart, so a limit under 8 hours keeps them out of the same week.
  • It holds across their whole week: shifts they already have that week, with another client, on another line, or on the schedule before the day a new draft takes over, count too.
  • Someone on several lines of business gets the smallest of their lines' limits. A pattern set has its own, which replaces their lines' while they have it.
  • It holds within each week, not from one week to the next.

One fixed day off a week

Left to itself, a draft gives each person their days off wherever coverage needs them least, week by week. To give each person the same weekday off every week, set Days off to One fixed day, the rest flexible on the line of business (Settings → Lines of business → the line → Edit). Their other days off still move, wherever coverage needs them least.

  • Who picks the day. Set it on a person's page: Edit, then Fixed day off. Where it's empty, generation picks it in their turn: the weekday their best shift would cover least, with everyone before them placed. So the fixed days spread across the week rather than all landing on a quiet Sunday. A draft says how many people have a fixed day off, and how many it picked.
  • It sticks. A day generation picked is kept on the person once the draft is used, so the next period starts from it, and their page says generation picked it. Change or clear it there at any time: a cleared one is picked again next time.
  • With other rules. Days off together in their contract sit next to the fixed day, unless days they can't work anyway make up the run, like a weekend their availability rules out. A day their binding availability rules out is a day off anyway, and time off doesn't move the fixed day.
  • Someone on several lines of business keeps a fixed day off if any of their lines asks for it. A pattern set has its own setting, which replaces their lines' while they have it.
  • If the fixed day leaves someone short of their contract's hours, because it's a day they could work and no other day fits, the draft names them.

Make a schedule

  1. Open Schedule and choose New schedule period.
  2. Choose the dates. A period is whole weeks, starting on your organization's first day of the week.
  3. Choose Create and generate. The first draft is generated in the background; on a big floor it takes a few seconds.
  4. Read the draft, and go through the checks below.
  5. Fix what needs it: change shifts, generate another draft, or Even out breaks… after your changes.
  6. Use draft to make it the schedule.
  7. Publish to agents, now or later.

Check it before you publish

  • Every line of business has a forecast. A warning above the figures names any days without one: Retention has no published forecast for October 4 to 10, so nothing is staffed then.
  • The draft is current. No warning saying the schedule needs generating again because someone moved or left. If there is one, it says who or what, and when it's about people, links to a draft for just them.
  • Coverage. Coverage, Short and Over for each week, then each day. On the coverage strip, red intervals are under 90% of the need, especially at the peaks.
  • Overstaffing. Blue intervals are over 125%. A warning says when people are scheduled where the forecast needs nobody: your shift patterns start earlier or end later than the forecast.
  • Time off. Time off during shifts lists the shifts approved time off lands on. Move or remove any you'd rather not keep.
  • Leavers and movers. People who've left have no shifts after their schedule ends. People who moved have shifts on their new line of business from the day they moved.
  • Breaks. After editing shifts, Even out breaks… puts breaks back where they cost the least.
  • Labor rules. No violations left, and you've read the warnings (how the checks work).

Read a draft

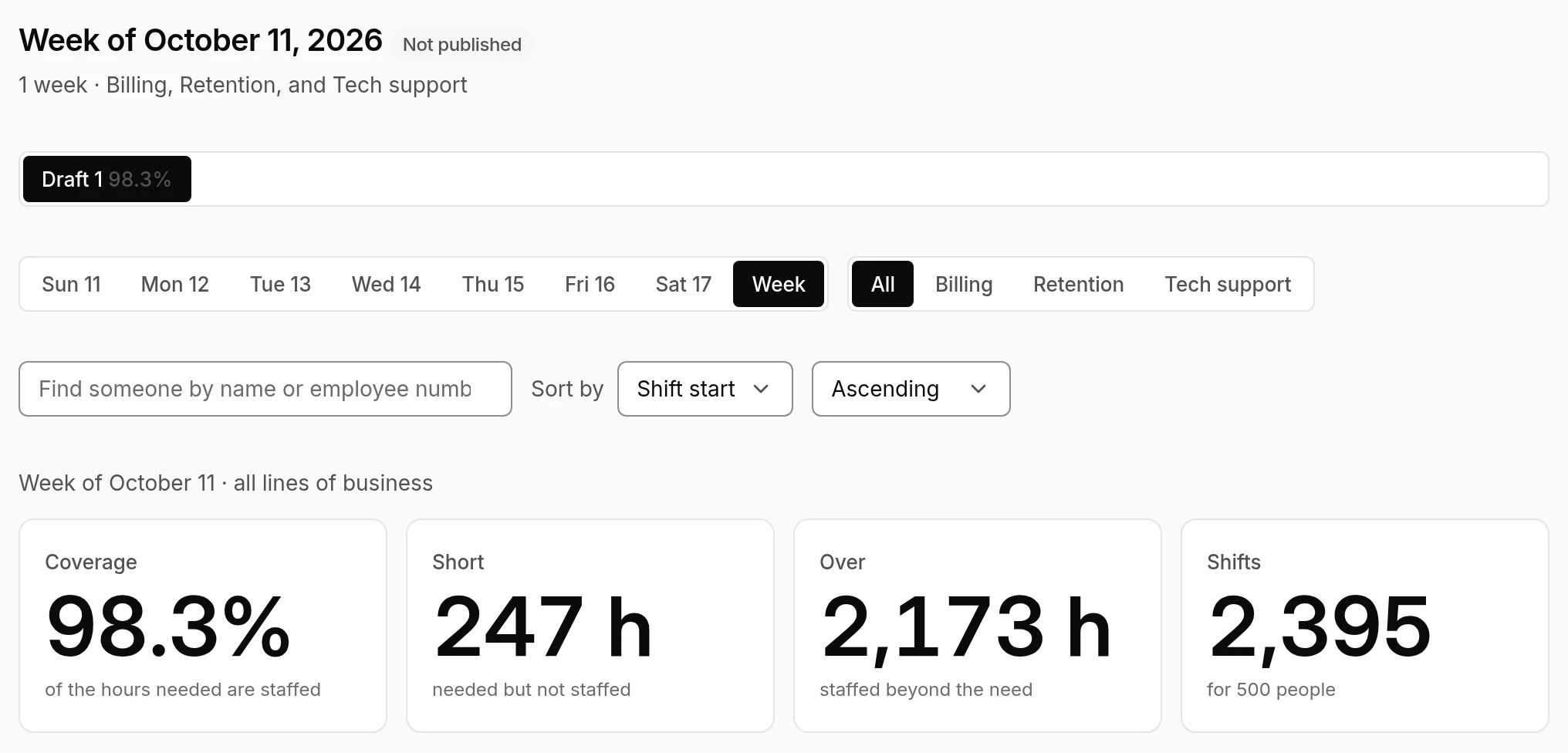

A generated week: the draft at 98.3% coverage, the day and line of business filters, and figures for coverage, hours short, hours over and shifts.
A draft: its figures for the week, all lines of business.
  • Coverage: the share of the hours needed that are staffed. Short is hours needed but not staffed; Over is hours staffed beyond the need, each also in FTE: for a day, the hours divided by the hours in an FTE day (7.5 to start with), and over a week, divided by the hours in an FTE week (37.5), so 75 hours short is 2 FTE (Settings → Organization); Shifts is how many, for how many people.
  • After it's published: coverage follows what happens. Approved exceptions take people off the phone (sick, late, absent, voluntary time off, an unplanned meeting) or put them on (overtime).
    • People away on those, or on time off approved since the schedule was made, use up the shrinkage the line's plan allows for that day first, all together: needed drops by up to that many, never below needed productive. So Short and Over show what's left to act on with overtime or voluntary time off. Overtime still to come is checked against the labor rules as it's recorded, as a change to a shift is: it counts with the shift it's next to.
    • With 10 needed at 20% shrinkage and 3 away, 2 were planned for: needed shows 8, 7 are on, and it's 1 short, not 3.
    • Time off known when the schedule was generated was planned around already, so it doesn't use up the plan. Time off being decided shows its coverage the same way.
  • How the need adds up: on a day, a line under the figures says where the hours needed come from, so you can check them without a spreadsheet: Needs 342.7 hours: 348.1 from the Reservations forecast published October 22, less 5.4 for people away within the 11.5% shrinkage plan. The forecast's figure already includes its shrinkage. If the forecast has changed since it was published, the line says when, and it names any line of business with no published forecast that day. A day already worked says Needed: it keeps what it was measured against, so later changes don't show there.
  • The night before: on a period's first morning, coverage includes the people still on from the period before's last night, and says so: Coverage includes 3 people still on from Sunday night. Their shifts are the period before's, so they aren't listed or counted in Shifts.
  • A week or a day, and all lines of business or one. Find someone by name or employee number, choose a team to show only its people, and sort the rows by shift start, shift end or name. The coverage and figures stay everyone's. A team lead's own team reads (my team).
  • Warnings above the figures say what generation couldn't do, or did on days with no forecast.
The schedule's week with Team Tulloch chosen: its 18 people's shifts, breaks and lunches, with the whole floor's coverage of 97.9% and 2,395 shifts for 500 people.
A week with a team chosen: only its people, with everyone's coverage and figures.

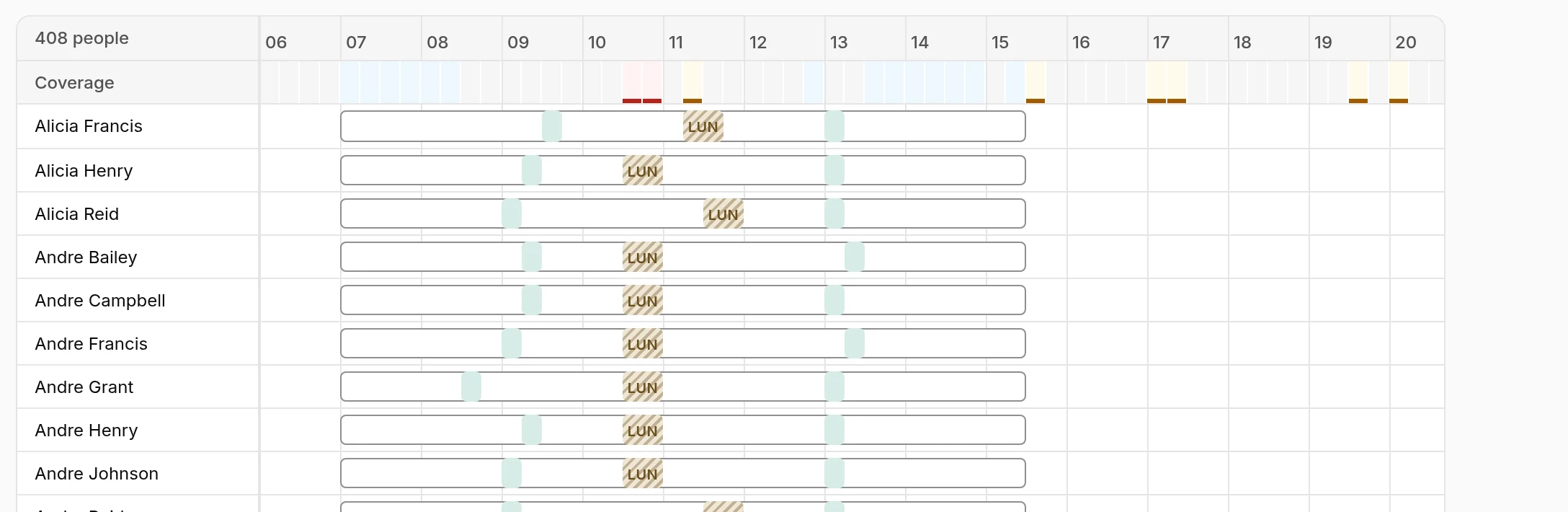

A day's grid: the coverage strip above, then a row per person with their shift, breaks and an unpaid lunch.
A day: the coverage strip, then a row per person.
On the gridMeans
Red intervalUnder 90% of the need
Amber interval90% to 100% of the need
Blue intervalOver 125% of the need
Point at an intervalHow many are on, of how many needed, and how that adds up: 1 of 1.0 needed: 2.0 from the forecast, less 1.0 for people away within the shrinkage plan
A rowOne person: their shift, its breaks, and lunch (striped when unpaid). Time off shows over the shift it covers. On the published schedule, so do approved exceptions, such as Absent or Late, in their color: point at one for its times.
Click a shiftIts times, line of business and breaks, with Edit

Download or print

Beside what's in view, Download CSV gives you its shifts as a spreadsheet, exactly as you've filtered them: the week or day, the line of business, the team and anyone you found. Each shift starting on those days is a row with:

  • the person's name, employee number and team
  • the line of business, the date, start and end, paid hours
  • its breaks, lunch and other activities with their times (marked (unpaid), or (paid) where one is paid that usually isn't)
  • any approved time off over it
  • whether it's published.

Times are the schedule's, as the grid shows them, so a shift is on the day you picked; someone who keeps another time zone has theirs in the last column. The file's name says the period, the dates, the line and the team. Anyone who can see the schedule can download it.

Print puts the grid on paper, landscape: a header with the period, the week or day, the line, the team and the time zone, then everyone in view (all of them, not only the rows you've scrolled to), with the days or hours at the top of each page. It prints in black and white: shifts outlined, activities in gray with their codes, unpaid ones striped. The coverage strip and figures stay on screen.

Adjust it

Change shifts

Choose a shift, then Edit:

  • Change its start, end or line of business.
  • Add, move or remove its breaks and other activities, like training or a meeting. Exceptions such as overtime or sick aren't added here: they're recorded under Exceptions, where overtime can run before or after the shift, and is checked against the labor rules too.
  • Remove the shift, or Add a shift from the draft's page.

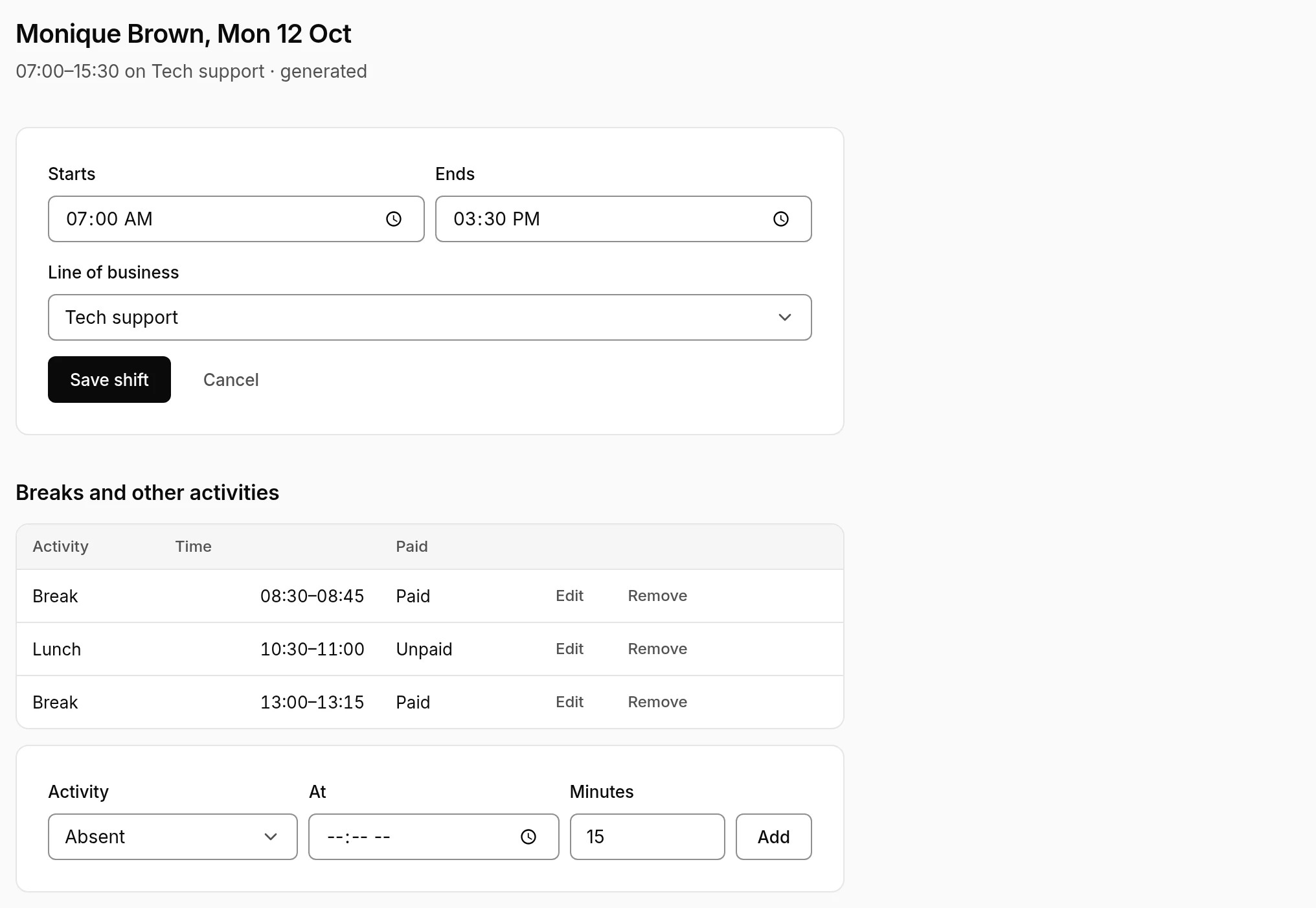

A shift's page: Monique Brown, Monday, October 12, 07:00 to 15:30 on Tech support, with its breaks and lunch and a form to add an activity.
A shift: its times and line of business, then its breaks and other activities.

Every change is checked against the person's labor rules: a change that breaks a rule set as a violation isn't made, and says why, and one that breaks a warning is made only when you confirm it with Save anyway: your name, the warnings and any reason you give go in the audit trail.

A person works one shift at a time, so a shift can't go over another of theirs: in the draft, on another client's schedule, or, in a draft for some lines of business, on the schedule's other lines, which stay as they are. It says when they already work.

Once a schedule is published, every change by hand needs a reason, to a break or other activity as much as to a shift (an activity is removed from its own page, where you give the reason), and the person is asked to look at their schedule again. Even out breaks…, Schedule an activity… and swaps don't ask for one.

With email set up, they also get one email, "Your schedule changed", a few minutes after your last change to their shifts, saying what each day was and is now ("Tue, Oct 6: was 08:00–16:30, now 11:00–19:30"). A change you undo in those minutes sends nothing. Only today and later count, in the person's own time zone: a change to a day that's already over isn't emailed, and a night shift counts as the day it starts, as the schedule shows it, so last night's isn't either.

Even out breaks

Even out breaks… moves breaks and lunches to where they cost the least coverage, from a day you pick, for all or some lines of business. It goes one person at a time, pass after pass, until nothing more helps. Then, or on Cancel, you're back on the schedule as you left it.

  • What moves: only breaks and lunches placed by generation, each within its shift pattern's window, in the same order.
  • What stays: shifts, days off, breaks placed by hand, and any break under way or starting within the current or next interval.
  • Labor law: each move is checked as a change by hand is. Where moving someone's breaks would break a rule, set as a violation or a warning, their breaks that day stay put, and it says whose and which rule.
  • Who's told: on a published schedule, only the people whose breaks moved, and they're asked to look again.
  • Afterwards: it says how many breaks moved and what that did to coverage, and whose breaks stayed put and the rule moving them would break. Then it checks labor law again.

More drafts

Generate another draft asks who it's for:

  • For everyone makes a new one from the latest forecasts, people and time off. With nothing changed, it comes out the same.
  • For some lines of business… makes a draft for just those. Only their people are scheduled, around their shifts on the other lines.
  • For some people… makes a draft for the people you tick, around everyone else's shifts: for someone moving to another line of business, say.
  • From a spreadsheet… makes a draft of shifts you already have: see Bring in a schedule you already have.

When a published forecast, a shrinkage rate or a service target changes, drafts and the schedule need what it now says from today on, and their figures follow at once: fix what's short or over on the schedule as it is, or generate again if you'd rather. Days already worked keep what they were measured against.

When people move or leave after a draft was made, the schedule says it needs generating again, and why. A draft made afterwards for the people or lines of business it names, added to the schedule, clears it.

Discard a draft you don't want. It goes to Trash for 30 days, with its shifts, and Undo or Put back in Trash makes it a draft again. See Trash.

Drafts are named by the number in their address: Draft 27 is at …/drafts/27.

Bring in a schedule you already have

If your floor already has a schedule for the period, in a spreadsheet or another tool, import it rather than typing every shift: Generate another draft → From a spreadsheet…, or Import shifts from a spreadsheet when choosing lines of business. Save it as CSV. Erlangly's own layout has one row per shift:

  • The person's employee number, the line of business (its name or code), the date (like 2026-10-12), and the start and end on the 24-hour clock, like 09:00 and 17:30. An end at or before the start, or marked (next day), is the next morning.
  • Breaks and other activities, if you have them, in an activities column, separated by semicolons: Break 10:30–10:45; Lunch 13:00–13:30 (unpaid). They're named as Erlangly names them (Break, Lunch, Training, Coaching…) and paid as that kind is, unless the row says (paid) or (unpaid). Without them the shifts have no breaks, and Even out breaks… can't add them: add them by hand, or in the file.
  • Times are in the period's time zone. A time zone column must name the same one.

Download CSV on a schedule writes these columns, so a downloaded schedule imports as it is; its other columns are left alone. The import page has a template too.

Two other layouts come in as they are, told apart by their columns, as many WFM systems export them. Ask a client for whichever theirs gives:

  • One row per shift with its breaks in columns: employee_id, shift_start_datetime and shift_end_datetime, then a start and an end for each break or lunch: break1_start_datetime, break1_end_datetime, lunch_start_datetime… (break3_…, lunch2_… for more; a shift with fewer leaves the rest empty).
  • One row per part of the day, as Calabrio exports it: employee_id, start_datetime, end_datetime and activity. SHIFT is the shift itself, and every other row, named as an activity is (BREAK, LUNCH, TRAINING…), goes on the shift it falls in.

In both, times are like 2026-10-12 09:00, and a line_of_business column is only needed for someone who works on more than one line that day. Whatever the layout, the shifts and breaks are imported exactly as the file has them: nothing places or moves them until you do.

Before anything changes, you see what it would import and what's wrong with any row:

  • someone not on that line of business
  • a shift overlapping another in the file or one they have in another schedule
  • approved time off
  • a date outside the period
  • a shift over 16 hours.

Import makes a new draft with the good rows: check its coverage and labor law, change it and use it like any other. A file with only some of the period's lines of business makes a draft for those, which replaces only their shifts: the schedule's shifts on the other lines stay, so the file's can't overlap them. Undo this import, on the import's page, discards the draft, until it's been used (and while there's another draft).

An import counts towards your license as generating does, a day at a time: on each day, the people with shifts in the file that day, with anyone whose shifts on the schedule's other lines of business stay that day. If its busiest day has more people than the license covers, the preview names that day; if there are more active agents than it covers, it says so. Either way nothing is imported until you add seats or make some agents inactive.

A file can have up to 12,000 shifts: four weeks of a 500-person floor, with room to spare. For more, split it by line of business and use each draft before importing the next, or make shorter schedule periods.

Use it and publish it

Use draft makes a draft the schedule and discards the others. Once there's a schedule, a new draft takes over from a day you pick: the start of next week unless you change it. The days before stay as they are. A draft for some lines of business, or some people, replaces only their shifts from that day.

It isn't used, or added, if it would put anyone on two shifts at once: one of its shifts over a shift they keep (on a line of business it doesn't replace, a night running into the day you picked, or for another client), or over another of its own. It says who, on what day and which two shifts, then who else it would put on two at once, and when. Move or remove one shift of each pair, or pick another day, then try again.

Once the schedule's published, its changes go to agents straight away, so labor law has a look first, as when publishing: the new shifts, and where they meet the days that stay. Violations stop it, and warnings wait for Use it anyway (or Add it anyway), with any reason you give (how the checks work).

Publish to agents checks the schedule first: against labor law, and for anyone it puts in two places at once, like two of their shifts that overlap, or one over their shift for another client.

The check findsWhat happens
Nothing in the wayIt's published.
ViolationsA page lists them by rule, with a link to each shift. Fix them, then publish again.
Warnings onlyThey're shown, with a box for your reason, and Publish anyway.

Agents then see their shifts in My schedule, on a phone too, and confirm them with Got it. With email set up, they're told it's published. The schedule's page shows how many people with a login have seen it.

Publish it later

Publish later…, beside Publish to agents, picks a day and a time for it to go out instead: Friday at 09:00, say, rather than when you finish at 23:00. The time is on the schedule's clock, before the period starts.

  • When you pick it: labor law has its look, as for publishing now. Violations stop it, and warnings wait for Publish later anyway, with any reason you give.
  • Until then: the schedule's page and the Schedule list say when it publishes, and changes you make meanwhile go out with it. Change or cancel moves the time or calls it off. Publish now sends it at once.
  • At the time: it's published in your name, and agents are told then. Labor law looks again first. If it finds violations, or warnings other than the ones you went ahead with, it isn't published. You and the other planners who see the client are told why, so one of you can publish it.

Only a first publication waits: once a schedule is published, its changes go to agents as you make them.

Activities supervisors schedule

Supervisors, and planners too, can put coaching, training, a meeting or another activity off the phone on people's shifts, in the hours where the published schedule has more people on the phone than needed. That includes nesting where it counts as off the phones, as it does on a new install and wherever a planner sets it so under Settings → Activities (how nesting is scored).

It's off until a planner turns it on for a line of business: Settings → Lines of business → the line → Edit, Supervisors can schedule activities where there's overage, agents to keep spare (1 unless you change it), and up to how many days ahead (3 unless you change it). The days after are left to your new drafts.

  1. On the schedule, choose Schedule an activity…. On a day you can schedule one for, tick the people you want beside their names first: they come along ticked, with that day.
  2. Choose the day, the activity, how long (15 minutes to start with), and who: anyone on the line's shifts that day. Nothing is chosen for you: no activity to start with, and no times until you ask. Team narrows the list to one team; coming from the schedule with a team chosen, it starts on that one. Select all ticks everyone in the list as it's shown: the team, or the names a search leaves.
  3. Find times says what's still to choose, if anything. Otherwise it shows, beside the names, only the start times where each person is on the phone on their shift throughout, and, in every interval with them all off it, the line still has its agents to keep spare (1 to start with) on the phone beyond what it needs, with shrinkage.
    • If you chose three or more and no time fits them all, it shows the times that fit the most of them, down to two, each saying who it leaves out.
    • Each time says who it schedules, and Copy copies the time with who it schedules and leaves out, to paste in a note.
  4. Schedule it puts it on the shifts of the people that time fits, and takes you back to the schedule on that day, with the line and team you had.
WhatHow
ActivitiesEvery planned activity off the phone except breaks and lunches.
What staysShift times, breaks and lunches. Supervisors can't move or change them.
Labor lawNothing a rule counts changes: the activity is paid work, and shift times, breaks and lunches stay. It's checked when you choose Schedule it all the same: anything it would break, a warning too, stops it and says which rule.
PeopleAsked to look at their schedule again, and told by email when it's set up.

Change a period, or start over

Edit period, on the schedule's page, renames a period and changes its dates.

You want toWhat happens
Rename itAny time. A name that was its dates follows new dates.
Make it longerMove its end later (or, before it's published, its start earlier), up to 13 weeks in all. The days added have no shifts in any draft yet, and the schedule says it needs generating again: generate a draft for everyone and use it from the first new day.
Make it shorter, or move its startThe drafts' shifts on the days taken off go. Once it's published, its start stays, and its end can't come before the end of the last week with published shifts.
Move it to another clientDelete it and make it again.

Delete period, on the same page, removes the period with its drafts and their shifts, and frees its dates. A period with only drafts goes to Trash for 30 days, where you can put it back while no other period has taken its dates. One that has a schedule, published or not, is deleted at once, after a warning: that can't be undone.

  • When it can't: once it has published shifts today or earlier. What the floor has worked stays on record, so rename it, change its end, or use a new draft from tomorrow on instead.
  • Who's told: people whose published shifts go no longer see them and, with email set up, are told their schedule is withdrawn.
  • What's kept: the audit trail records the period and who deleted it, moved it to Trash or put it back.

To start over after picking the wrong dates or client, delete the period, then choose New schedule period. Removing sample data (Settings → Organization) also removes the schedule periods that only had the sample's shifts, published ones too.

How it works

How a draft is made, and how contracts, binding availability, time off and night shifts shape it: How Erlangly builds a schedule.

Labor rules have their own page: Labor rules, with how the checks work and what each country's rules check.

Night shifts, which belong to the day they start, are explained in How Erlangly builds a schedule.

Common issues

You seeWhy, and what to do
Billing: 211 h scheduled when the forecast needs nobody, mostly 06:00–07:00The shift patterns start earlier or end later than the forecast needs. Narrow their starts or lengths, then generate again.
Retention has no published forecast for …, so nothing is staffed thenPublish a forecast for those days. The draft and the schedule then need what it says, from today on, and the warning goes. Generate again to staff them, or add shifts by hand.
Billing has no published forecast for October 12, the day after this period, so Sunday's night shifts were planned as if nobody's needed after midnightThe period's last night runs into the next day, which no published forecast covers. Publish a forecast for it, then generate again.
Night is for 3 people in this draft whose binding availability ends just before midnightTheir availability stops at 23:59, say, so none of the pattern's shifts past midnight fit it. If they can work on, end their availability the next morning instead, like 22:00 to 06:00.
No handle time for Billing on …, so the agents it needs then can't be worked outIts forecast has contacts but no handle time, so nobody is scheduled on it those days. Import its volumes with handle time and recalculate its forecast, then generate again. When only some intervals lack it, the draft counts only the contacts that have one and says how many intervals: override their handle time on the forecast.
On Tue, Oct 20 this schedule period would have 26 people, and your license covers 25The license counts a period's busiest day: everyone who can work that day, and anyone whose shifts on the schedule stay. A leaver counts until their effective date and a new person from their hire date, so someone replacing a leaver from that date takes the same seat. Check the hire and leaving dates of the people that day, or add seats.
Someone has no shiftsCheck their lines of business, contract, binding availability, time off, leaving date and shifts for other clients.
Short at the peaks while people have hours to spareThe patterns' start windows or lengths don't reach the peak, or binding availability rules people out.
The schedule says it needs generating againIt names who changed, or the line of business that moved. Make a draft for just those people or lines of business and add it to the schedule.
This draft couldn't be generated: Erlangly stopped while generating itErlangly stopped partway, when the server ran short of memory, say. A draft still generating after 30 minutes says so. Generate another draft, then discard this one.
A change asks for Save anywayIt breaks a labor-law warning. Saving records your name, the warnings and any reason you give.
Publish goes to a list of violationsFix each one, opening its shift from the list, then publish again.
A schedule wasn't published as plannedAt its time, labor law found violations or new warnings, or whoever planned it can no longer publish. The notification says which. Open the schedule, sort it out, then publish it, now or later.
… would work two shifts at once on …One of the draft's shifts is over a shift they keep: on a line of business the draft doesn't replace, a night running into the day you picked, or for another client. Move or remove one of the two, or use the draft from another day.
… already has a period on some of these datesAnother period for that client covers some of those days. Change its dates, or delete it, with Edit period on its page. See Change a period, or start over.

Terms used here

In the glossary: schedule period, draft, schedule, coverage, short, over, shift pattern, pattern set, violation and warning.

Next step

Once it's published, Erlangly scores adherence against it, and the wallboard shows the floor against it right now.
